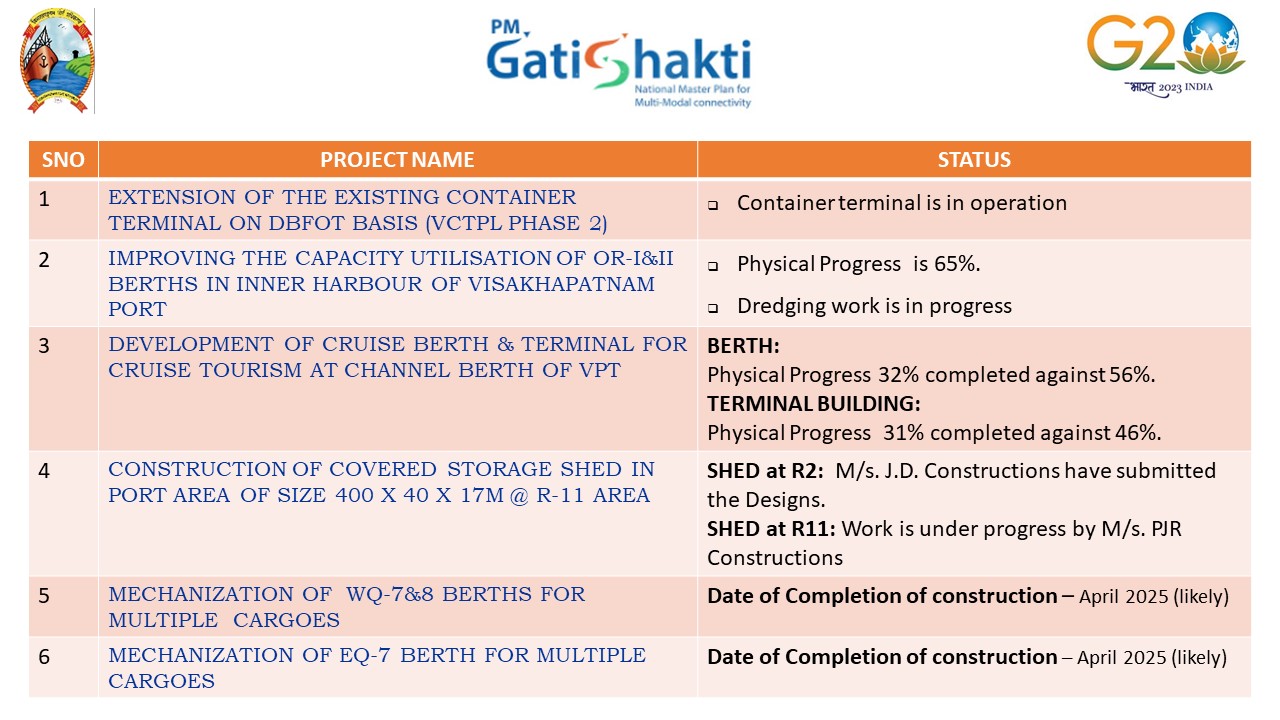

Status Updates

The last update was on 15-04-2025

S.NO Project Name Status
1 Improving the capacity utilization of OR-1and OR-2 berths (Construction of OR-I, OR-II & OR-III berths) Work completed on 21.03.2025
2 Development of Cruise Berth & Terminal Building for Cruise Tourism at Channel Berth of VPA

Berth and Terminal Buildings were completed.

Inaugurated on 04.09.2023
3 Construction of covered storage sheds in Port area.

Shed no.1: 400x40x17m at R-11 area.

Work completed on 22.11.2023

Shed no.2: 300x40x17m at R-11 area.

Work completed on 19.05.2023 and inaugurated on 04.09.2023

Shed no.3: 200x40x17m at R-10 area.

Work completed on 31.01.2025.

Shed no.4: 200x30x17m at R-2 area.

Work completed on 30.10.2023 and inaugurated on 28.02.2024

T5 Shed: 104x30x17m at dock area

Work completed on 27.02.2024

4 Mechanization of WQ-7&8 berths for multiple cargoes.
Date of Completion of construction — Nov 2026 (likely)
5 Mechanization of EQ-7 berth for multiple cargoes Date of Completion of construction — Jan 2027 (likely)
